Lean Portfolio Management: benefits, challenges, and how to make it work

Most portfolios still run on a comfortable but dangerous rhythm: an annual plan is approved in Q4, budgets are locked, projects march through their milestones, and by the time results land the market has already moved. Everyone did their job. The company still fell behind.
Lean Portfolio Management (LPM) is the response to that pattern. It changes how planning, funding, and evaluation happen so that decisions can catch up with reality. In exchange, it asks something uncomfortable: that executives, PMOs, and delivery teams give up a good part of the certainty they had built around traditional predictive planning.
This post walks through what LPM actually is, where it delivers value, where it breaks down, and how to tell whether it is worth adopting in your organization.
The short version
LPM improves the way organizations make decisions about project and product development. In practice, three things change:
- Planning, funding, and assessment become more frequent and dynamic.
- Decisions are decentralized.
- Portfolio management extends to the whole business, not just the PMO.
The promise is escape from the iron triangle of budget, schedule, and scope. The catch is that it only works if the mindset shift is real. One caveat worth flagging early: watch for what practitioners call the illusion of adopting agile, where management champions the method while teams quietly keep doing waterfall behind the scenes.
Why traditional portfolio management runs out of road
Traditional portfolio management is built for stability. It assumes you can plan a year ahead, allocate resources against that plan, and evaluate outcomes when the year is over. That assumption made sense when markets moved slowly. It rarely does anymore.
Consider WeCare.much, a fictional healthcare company running an intensive slate of transformational and external projects across IT, marketing, R&D, facility deployment, and product placement. Project managers are generally satisfied. Individual projects finish inside their expected parameters. And yet, business executives keep asking the same uncomfortable question: why does the portfolio not seem to deliver?
The answer is usually a combination of four things:
- Outdated outcomes. By the time projects finish, the market has moved.
- Lack of strategic alignment. Approved initiatives no longer match current priorities.
- Approval of low-value initiatives. Nobody re-evaluates once the plan is signed.
- Overly long evaluation cycles. Course corrections come too late to matter.
WeCare.much has a strategic plan. But most projects enter a dark zone from approval to delivery, with little oversight in between. Meanwhile, new objectives compete for the same scarce resources. Nothing is on fire, but the company falls a little further behind in industry rankings every day.
The board decides to adopt Lean Portfolio Management. This is where the real work begins.
The framework
Lean Portfolio Management is described by the Scaled Agile Framework as a set of organization and workflow patterns that guide enterprises in scaling lean and agile practices. It is one of seven disciplines a business must adopt to become an agile company, and SAFe splits all company activities into two blocks: execution and strategy.

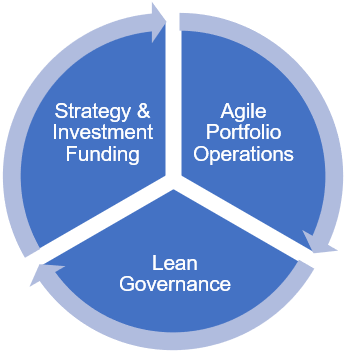

LPM sits on the strategy side and covers three dimensions:
- Strategy and investment funding, so that the enterprise strategy is executed with the right level of investment.
- Agile portfolio operations, coordinating and supporting decentralized value stream execution.
- Lean governance, providing forecasting, budgeting, and measurement of portfolio performance.
You do not necessarily need to have all seven SAFe core competencies fully rooted in your organization to implement LPM. But LPM is not just a framework or a different way to run meetings. It is a change of mindset, especially in management areas.
What has to be true before you start
LPM implementation requires two conditions to be met before anything else is worth attempting:
- A directive from the board. The PMO should not try to implement LPM alone without an explicit mandate. It can advocate for it, but the changes required are too significant to be driven from the middle.
- Business executives’ involvement. LPM depends on intensive tracking, evaluation, and interaction between business managers and portfolio managers. Without that, it becomes ceremony without substance.
Adopting any framework unconditionally is rarely the best choice. Consider cherry-picking what may work for your organization before you commit to the full method.
Value streams: the unit of funding
Once the conditions are in place, the first structural change LPM introduces is a shift from funding projects to funding value streams.
A value stream is the sequence of steps used to deliver value to a customer. It contains the people, the systems, and the flow of information involved in delivering that value. LPM defines a SAFe portfolio as a collection of value streams for a specific business domain.

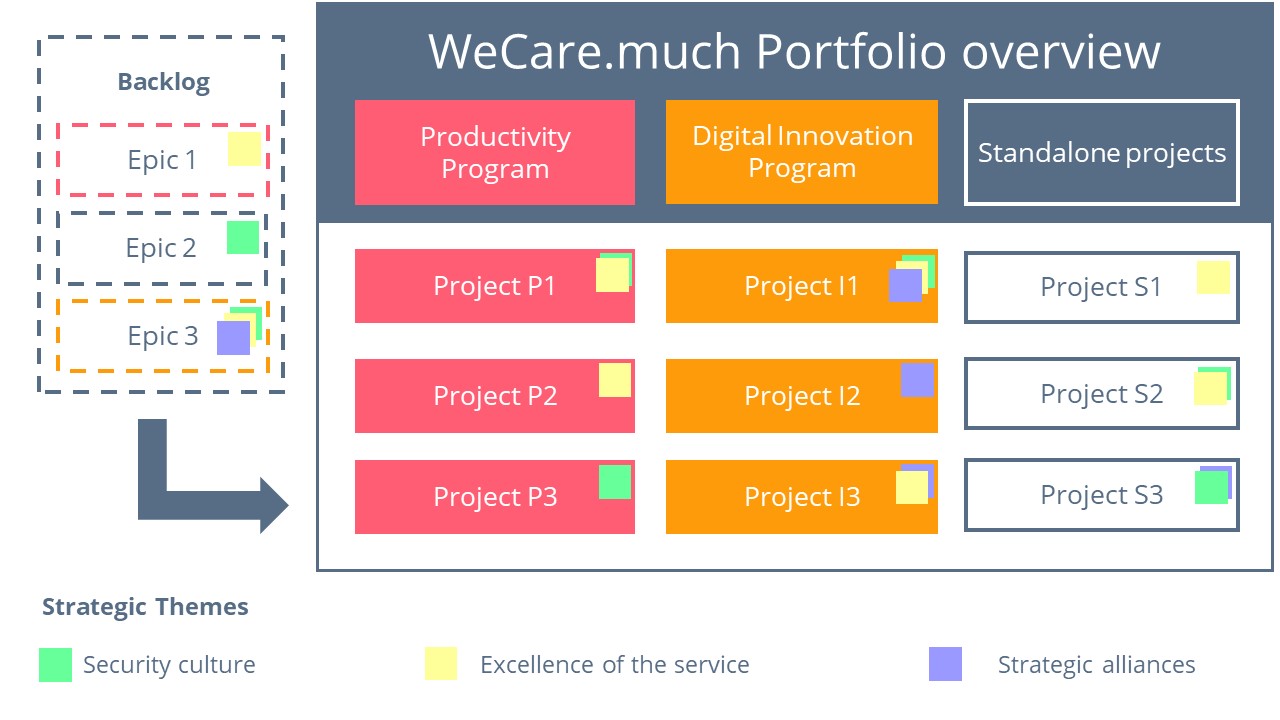

WeCare.much knows that 20% to 30% of healthcare spending is wasted. To reduce that, they define the value streams with the most impact, for example “routine admission laboratory testing for general medical patients.” Value streams become the budget driver that allocates funds to the projects and activities that add the most value.
This maps directly to how a modern PPM tool structures budgeting. When funding a value stream, you typically set a top-down budget covering workforce, purchases, and revenue, and then let bottom-up estimates from the projects that live inside it inform whether that ceiling is realistic. In ITM Platform, this is exactly the structure the project budget module uses, with top-down and bottom-up figures reconciled continuously against actuals.
Decentralization: harder than it sounds
Decentralization is a defining feature of the lean approach. LPM in particular takes advantage of:
- Dynamic demand management
- Decentralized decision-making
- Self-managed value streams
The theory is compelling. The practice is harder. Many organizations struggle to achieve real decentralization because stakeholders find it uncomfortable to hand control to teams they see as too focused on their specialism and too far from the customer or the industry. Some companies have quietly reverted to centralization and reinforced their PMOs after LPM adoption attempts stalled.
The lesson is not that decentralization is wrong. It is that decentralization without competent teams and clear guardrails becomes chaos, and organizations react to chaos by tightening control.
Long-term planning with epics

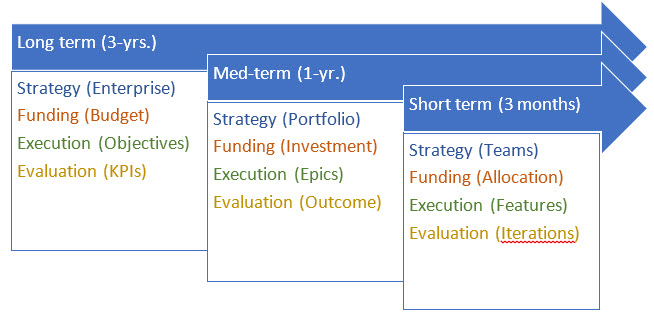

LPM is not improvisation. It requires a solid plan based on business strategy, typically covering a three-year horizon. The recommended approach is to build a backlog based on epics (high-level, user-language descriptions of features), then move to the live portfolio and its programs.
Programs group projects that share commonalities or management synergies. Themes help stakeholders understand how funds and resources are distributed across the portfolio.
This is where component prioritization becomes critical. Deciding which epics get funded first, and which get pushed to a later horizon, is not a spreadsheet exercise. It is a structured conversation about strategic value versus cost, and it works best when the tool supports it. The Strategic Alignment feature in ITM Platform, for example, walks users through business goal prioritization, component prioritization, and component selection, using methods like quantitative rating, qualitative Harvey balls, or pairwise comparison via the Analytic Hierarchy Process. Scenarios (optimistic, realistic, pessimistic) let you keep the same underlying epics but change the selection based on budget and market conditions.
If you want to go deeper into this, our post on strategic alignment and selecting the most valuable portfolio covers the prioritization mechanics in more detail.
Shorter plans: quarters, not years
Once you have a three-year plan, break the strategy into smaller periods, typically years, then again into quarters. Each cycle is individually funded, executed, and assessed.
Managers at WeCare.much used to agree that all company resources were allocated. But few thought resources were actually working on the things that mattered. After adopting LPM, long-term plans were broken down into more manageable activities. Resource and funding allocation for those activities became not only more manageable but more accurate. Outcomes are more closely assessed to make sure they bring the expected value to the company.
Funding follows planning
Funding must match the planning schedule. If planning is divided into long, medium, and short-term horizons, budgeting has to mirror them with three-year, one-year, and quarterly funding allocations.
| Planning horizon | Budget horizon | What gets funded |
|---|---|---|
| Three-year plan | Vision-level budget | Value streams and long-term epics |
| One-year plan | Annual budget | Programs and initiatives inside each value stream |
| Quarterly plan | Rolling budget | Specific activities, resources, and purchases |
Value streams are budgeted first, then projects and activities are funded within them, allocating the resources and money required to deliver the highest-value work.
The MVP loop: pivot, persist, or kill

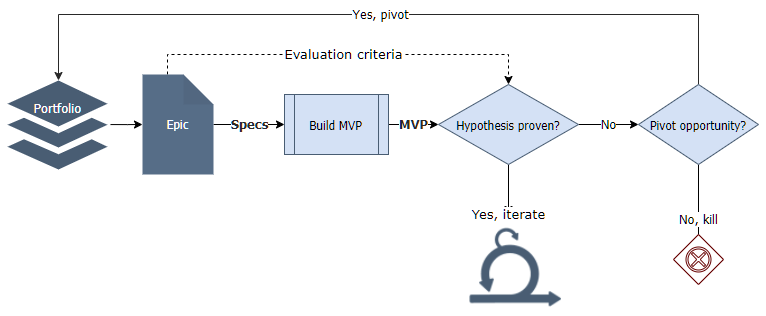

For each outcome, LPM leans on the Minimum Viable Product (MVP) concept, the cornerstone of any lean approach. An MVP is a version of a new product that allows your team to collect the maximum amount of validated learning about customers with the least effort.
Once the MVP is available, you evaluate the outcome and verify it against the hypothesis. You then decide whether the project is worth pursuing, pivoting, or killing.
This is the hardest decision in the whole method. It is human nature to persist rather than admit we were wrong. To evaluate objectively, you need two things:
- A clear hypothesis and straightforward success criteria defined before the MVP is built.
- A team that understands what the sunk cost is and disregards it in decision-making.
The sunk cost must be ignored as a parameter in pivot, persist, or kill decisions.

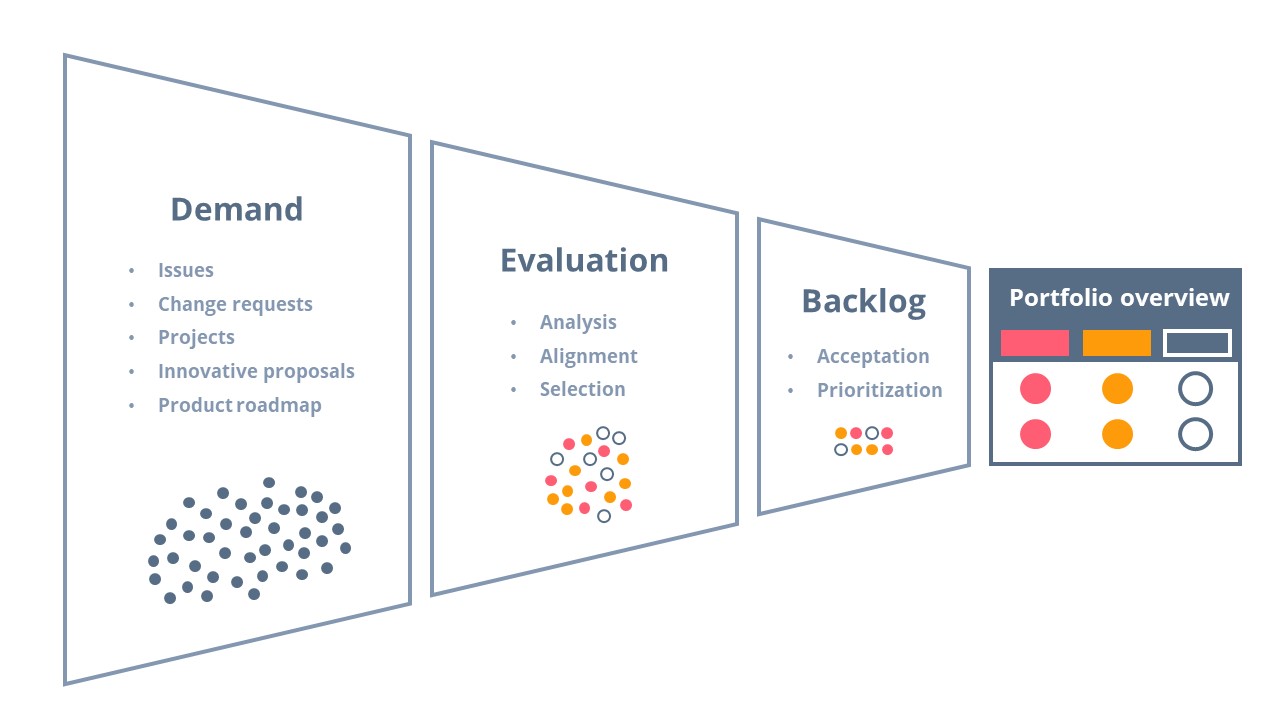

Opportunity assessment: making room for the unplanned
Not every good idea shows up in the annual plan. The opportunity assessment process asks whether unplanned initiatives may have more value than others currently being developed.
LPM explores those ideas, translates them for business managers, and gives them the tools to prioritize (or replace) current initiatives with those that add more value. Agility is achieved when a company reacts to the competitive environment inside its strategy guidelines, not outside of them.
To keep the balance between new ideas and the long-term plan, LPM uses the concept of budget guardrails, which ensure that:
- The strategic vision is adequately funded.
- Capacity is allocated as efficiently as possible.
- New initiatives are assessed before being approved.
The communication cost: meetings, and more meetings
LPM stands out for its requirement of frequent and efficient communication between teams. The main forum is the quarterly demand-delivery meeting, which has two goals:
- Demand (usually enterprise managers) explains what is needed and why.
- Delivery (portfolio and delivery managers) assesses whether they have the capacity or if there are roadblocks to execution.
This is not overhead. It is the mechanism that makes decentralization safe. Without it, teams optimize locally and the portfolio drifts from strategy.
Waterfall inside a Lean Portfolio
Can waterfall projects live inside an LPM approach? Absolutely. When you run projects with a well-known sequence of activities and low uncertainty, waterfall makes sense and coexists happily with agile-based projects. This is one of the reasons LPM works better as a governance layer than as a delivery method: it does not force every team to change how they build things, only how the portfolio funds and evaluates them. Our post on portfolio prioritization of innovation projects covers how to balance these different kinds of work inside the same portfolio.
Caveats and honest challenges
We have deliberately included the arguments against LPM to give you the whole picture. The most common criticisms are:
- It is designed as a one-size-fits-all.
- It is heavily consultant-dependent and certification-eager.
- It is not used in most large software organizations (Google, Facebook, Microsoft, Netflix, etc.).
- It is stressful for stakeholders and teams, who often find workarounds.
- In practice, the customer’s voice can go missing.
- It arguably conflicts with the first tenet of the Agile Manifesto: individuals and interactions over processes and tools.
For more challenging viewpoints, read Jeff Gothelf’s SAFe is not Agile, Marty Cagan’s Revenge of the PMO, or Steve Denning’s Understanding Fake Agile.
How to tell if LPM is working for you
To assess whether Lean Portfolio Management is actually delivering, go back to the two reasons you adopted it in the first place:
- Has the time to market improved?
- Has the market fit improved?
Then evaluate the cost of the change itself:
- Is there any increase in defects?
- Has productivity improved?
- Has employee satisfaction been affected?
- Do the benefits outweigh the cost?
Honest answers to those six questions are more useful than any framework compliance checklist.
Where a PPM platform fits
LPM is not about tools. It is about processes, mindset, and actions. But some parts of it are almost impossible to sustain without the right data infrastructure. You need aggregated visibility, transparent funding, and a way to compare what was planned with what actually happened, continuously, across dozens of initiatives.
That is where a platform earns its place. In practice, these are the capabilities that matter most for LPM:
- Strategy: value-based epic prioritization and scenario analysis (see the Strategic Alignment feature).
- Portfolio: a global view of initiatives across value streams and programs, with financial, schedule, and progress tabs at portfolio level (see Portfolio Management).
- Budgeting and controlling: top-down and bottom-up budgets for hours, purchases, and revenue, with actuals updated in real time from timesheets and invoices (see Project Budget).
- Work management: plan, assign, and track progress in real time regardless of whether the underlying project runs agile, waterfall, or hybrid.
Takeaways
- LPM can improve your time-to-market and product fit.
- It is demanding. Make sure your organization understands and accepts the challenge.
- Get the strongest possible executive sponsorship.
- LPM is part of a larger framework. Decide which parts of the big picture you need alongside it.
- Understand and plan for the flip side. LPM may not be right for your organization.
- Map the value streams before anything else.
- Decentralization is the goal, but it is hard to achieve without capable teams and guardrails.
- Plan long-term with epics and organize the portfolio around programs.
- Break down long-term plans into quarterly activities and fund them at that cadence.
- Develop MVPs, evaluate them objectively, and pivot or kill when the data says so.
- Make room for opportunity assessment so the portfolio can adapt without losing coherence.
- Encourage demand-delivery interactions as a recurring, structured practice.
- Measure whether LPM is delivering, and treat it as a continuous improvement system.
