Plans are only good intentions unless they immediately degenerate into hard work. Peter Drucker

Plans are only good intentions unless they immediately degenerate into hard work, Peter Drucker

Every project manager has lived through it: a beautifully crafted plan, approved by everyone, that quietly stalls the week after kickoff. Tasks slip, status updates get vague, and by the time the first deadline arrives the team is improvising. Drucker’s quote is so often repeated because it captures the most uncomfortable truth in project management. The plan is not the work. The work is the work.

Closing the gap between plan and delivery is rarely a question of intelligence or effort. It is a question of three disciplines that rarely get the same attention as the planning phase itself: a credible schedule, fluid team communication, and honest progress tracking. Get those right and the plan stops being a document and starts being an engine.

Building a plan the team can actually execute

A good plan is much more than a list of deliverables and dates. It identifies every requirement, breaks the work into pieces that a real person can finish in a reasonable amount of time, sequences those pieces according to their dependencies, and groups them so that the team produces the best possible result with the least friction.

That sounds obvious, but most plans fail one of those tests. Common symptoms:

  • Tasks that are too big to estimate honestly, so the estimate is essentially a guess.
  • Dependencies that live only in the project manager’s head.
  • A timeline that assumes 100% allocation from people who are also busy on three other initiatives.
  • A baseline that is never saved, so there is nothing to compare against later.

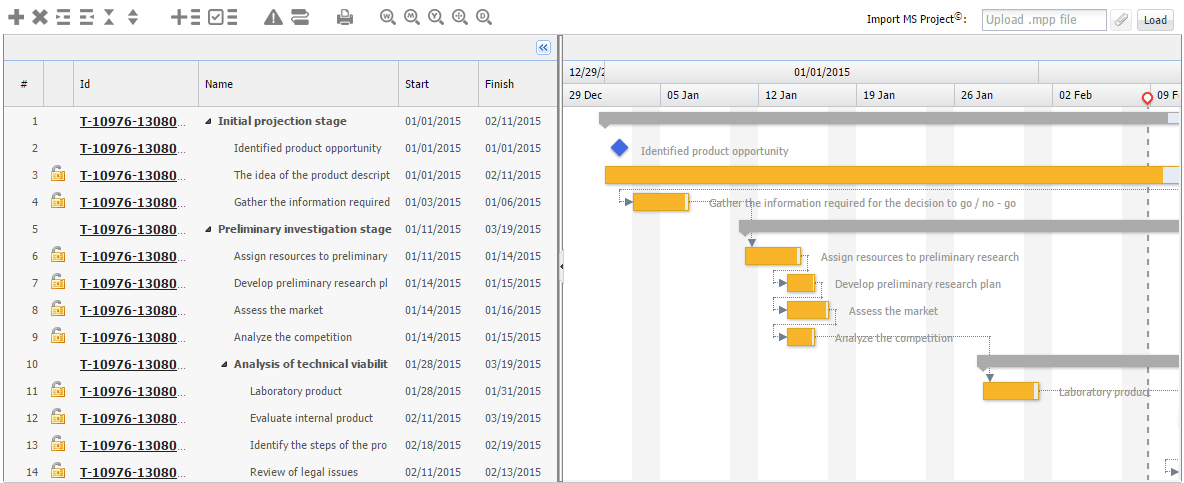

A visual planning surface helps surface these problems early. A well built Gantt chart shows the tasks, the dependencies between them, the critical path, and the baseline you committed to. When the plan lives in a tool such as the interactive Gantt, the project manager can spot conflicts before they become delays, simulate changes without rewriting the schedule, and import existing plans from MS Project without losing the dependency structure.

If you want a deeper look at how the schedule itself should be built, the companion article on what a project schedule is walks through the formats, the role of milestones, and how to keep a baseline that actually means something.

A plan without a baseline is a forecast. A plan with a baseline is a commitment you can measure against.

Communication is the bridge between plan and work

Even the best plan collapses if the team does not know what is expected, when it is expected, and how their work connects to everyone else’s. Assigning tasks is the easy part. The hard part is keeping the conversation alive across the entire life of the project so that decisions, changes, and small obstacles are surfaced before they become problems.

Three habits separate teams that execute from teams that drift:

  • Every task has one accountable owner. Shared ownership is shared confusion. One name on the task, with clear acceptance criteria.
  • Status conversations happen in the same place as the work. When updates live in scattered emails and chat threads, they get lost. Anchoring the conversation to the task itself keeps context intact.
  • Decisions are written down. Verbal agreements have a shelf life of about 48 hours. A short note attached to the task or the project is enough.

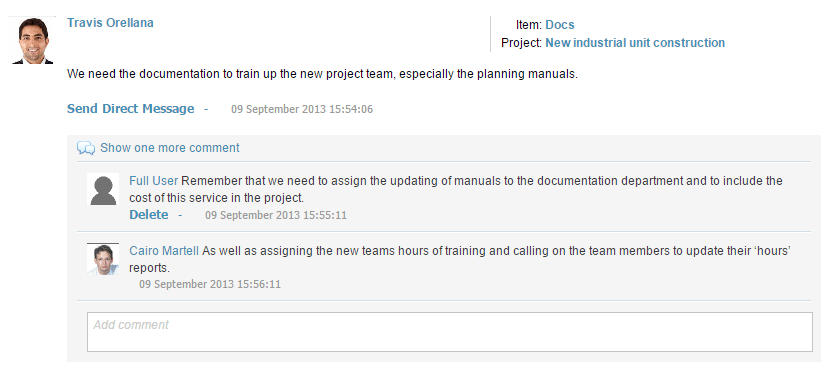

ITM Platform’s built-in social channels and task-level conversations are designed for exactly this: keeping the dialogue glued to the work, so the project manager does not have to chase people for context. For a fuller treatment of the topic, the guide on project communication covers the rituals, channels, and stakeholder mapping that keep a team aligned without drowning it in meetings.

Tracking progress before there is a problem

Drucker’s “hard work” only becomes visible if you can measure it. The single most common cause of project surprises is not bad luck, it is late reporting. By the time a deadline is officially missed, the slip has usually been forming for weeks.

The discipline you want is frequent, low-overhead progress reporting at the task level. Team members report progress as part of their regular workflow, not as a separate chore at the end of the month. The project manager then has the data to react while there is still time to react.

There are two complementary views of progress that every project should track:

ViewWhat it answersBest for
Reported progressWhat the person doing the work says is doneDay-to-day coordination, blocker detection
Calculated progressWhat the data says is done, weighted by task duration or effortStatus reporting, executive dashboards, EVM

Reported progress is fast and human. Calculated progress is objective and comparable. The two together give the project manager a stereoscopic view of execution. The platform offers multiple lightweight ways for task owners to report progress (from the timesheet, the task tracking section, or the Gantt itself), and rolls those updates into a calculated progress figure that the project manager can trust.

Calculated progress (%) = Σ (task progress × task weight) ÷ Σ (task weight)

When reported progress and calculated progress diverge significantly, that is your early warning. It usually means the team is optimistic about tasks that have not actually moved, or that the plan is missing work that is being done off the books. Either way, you want to know now, not at the next steering committee.

Bringing it all together

The thread that runs through Drucker’s quote is that planning, communication, and tracking are not three separate activities. They are one continuous loop:

  • The plan tells the team what hard work looks like.
  • Communication keeps the team aligned as the plan meets reality.
  • Tracking tells the project manager whether the hard work is actually happening, while there is still time to adjust.

Skip any one of the three and the plan reverts to good intentions. Run all three together and the plan becomes the operating system of the project.

Next steps

  • Try ITM Platform on your own project with a free 14-day trial and see the Gantt, communication, and progress tracking working together on real data.
  • Browse the helpcenter for step-by-step guides on planning, tracking, and reporting.
  • Save a baseline on your next project and track it weekly. The discipline matters more than the tool.
