What to Do When a Task Gets Delayed

No matter how carefully you plan a project or how strong your team is, sooner or later a task will slip. Someone underestimates the effort, a dependency arrives late, priorities shift, or a person gets pulled onto something else. The delay is not the interesting part. What separates a well-run project from a chaotic one is what happens in the hours and days after the slip is noticed.
The instinct in many organizations is to react emotionally: assign blame, add pressure, or promise that “we’ll catch up next week.” None of those responses fix anything. What actually works is a short, disciplined sequence that a project manager can walk through every time a task falls behind.
This article lays out that sequence in five steps.

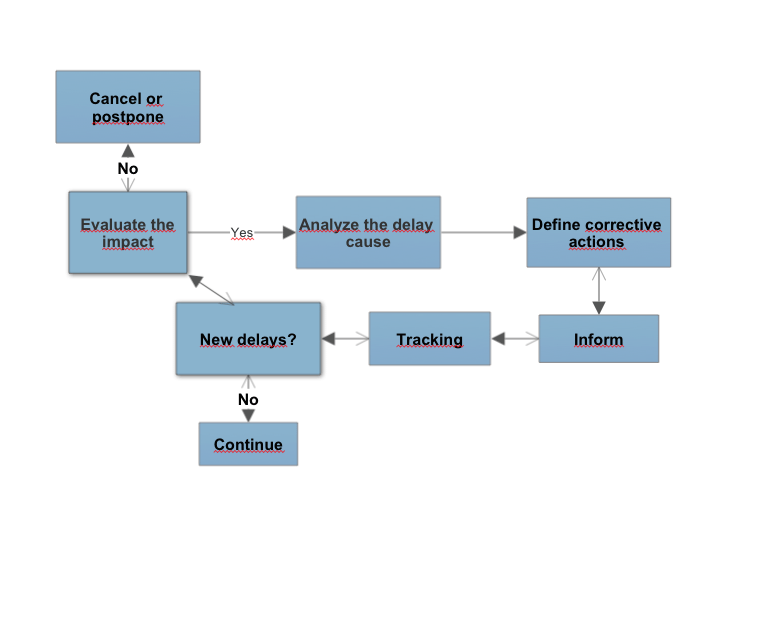

1. Assess the impact before you act
Not every delayed task deserves a rescue operation. Some tasks are nice-to-have, some sit off the critical path, and some can be safely dropped or pushed to a later phase. Before spending energy on recovery, ask two blunt questions:
- Does the delay threaten the project as a whole? If the slip reduces the probability of hitting a milestone, a delivery date, or a contractual commitment, it matters. Recover the lost time.
- Does the delay cascade into other tasks? If successors depend on the delayed task, waiting will multiply the damage. Recover the lost time.
If the answer to both is no, document the delay and move on. Not every fire needs to be fought.
A one-day slip on a task nobody is waiting for is noise. A one-day slip on the critical path is a schedule risk.
A clear view of task dependencies and the current baseline makes this triage much faster. If your planning tool lets you compare the live plan against a saved baseline, you can see the deviation at a glance instead of guessing. In ITM Platform, that comparison is built into the project baselines feature, which captures schedule, effort, cost, and revenue at each control point.
2. Find the real cause, not the convenient one
Once you know the delay matters, sit down with the people doing the work and diagnose the cause. The goal is understanding, not blame. Most delays trace back to one of three patterns:
| Cause | What it looks like | Common signal |
|---|---|---|
| Multitasking | The assignee is spread across too many parallel tasks | Actual effort trickles in slowly across many days |
| Low productivity | The tools, process, or context are getting in the way | Actual hours climb but progress does not |
| Late start | The task began later than planned because a predecessor slipped | Task never appeared on this week’s plan |
The difference between “the person is slow” and “the person is working on four other things” is enormous, and it changes the corrective action completely. Comparing estimated effort against actual effort task by task usually reveals which pattern you are looking at. ITM Platform’s effort management model makes this comparison explicit, so the diagnosis is a matter of reading the numbers rather than a matter of opinion.
3. Choose corrective actions that fit the cause
The corrective action must match the diagnosis. Applying the wrong fix wastes time and often demoralizes the team.
If the cause is multitasking
Reduce the load. Pause or reprioritize lower-value tasks so the assignee can focus on the delayed one. Adding more people is rarely the answer; adding fewer parallel demands almost always is.
If the cause is low productivity
Look at the tools, the process, and the context. Is the person waiting on approvals, missing information, or fighting a clunky workflow? Fix the environment before you push the individual harder.
If the cause is a late start
You cannot fix a delay you inherited from a predecessor. What you can do is protect the tasks downstream: renegotiate the deadline, compress the remaining work, or narrow the scope so the finish date still holds.
For any of these actions, update the plan so the change is visible. A corrective action that lives only in a conversation will be forgotten by next week.
4. Communicate the delay and the plan
Every delay that matters should be reported, and the report should include both the problem and the response. The audience is usually two groups:
- Sponsors and management, who need to know that the schedule is at risk and that a specific action is under way.
- The team, especially anyone whose work depends on the delayed task, so they can adjust their own plans.
Keep the message short and factual. State what happened, why it happened, what you are doing about it, and what you need from the recipient. Vague reassurance (“we’ll catch up”) erodes trust faster than any real slip. Concrete plans, even imperfect ones, build it.
If the delay is meaningful enough to change the finish date or the budget, it belongs in your project’s risk and issue register. Treat it as an issue with an owner and a due date, not as a talking point that resurfaces in the next status meeting.
5. Monitor and learn
Corrective actions only work if someone watches them. In the days and weeks after the fix, check that:
- The action is actually being applied, not filed away.
- The delayed task is closing at the new expected rate.
- No new delays are appearing in the tasks that depend on it.
Then, once the dust settles, capture what you learned. If multitasking was the cause on this project, it is probably the cause on the next one too. If a specific process step keeps blowing up estimates, revisit the estimate rather than the person. Turning individual delays into shared knowledge is what stops the same mistake from repeating across projects.
Recovery in one page
To keep the sequence handy, here is the same playbook in one place:
- Assess the impact. Is the delay on the critical path or blocking other tasks?
- Find the cause. Multitasking, productivity, or a late start?
- Apply the fitting fix. Rebalance load, improve the environment, or protect the downstream.
- Communicate. Sponsors, team, and the risk and issue register.
- Monitor and learn. Watch the action, close the task, capture the lesson.
Every step is small. The habit of running them in order is what compounds over time into projects that finish on time more often than not.
